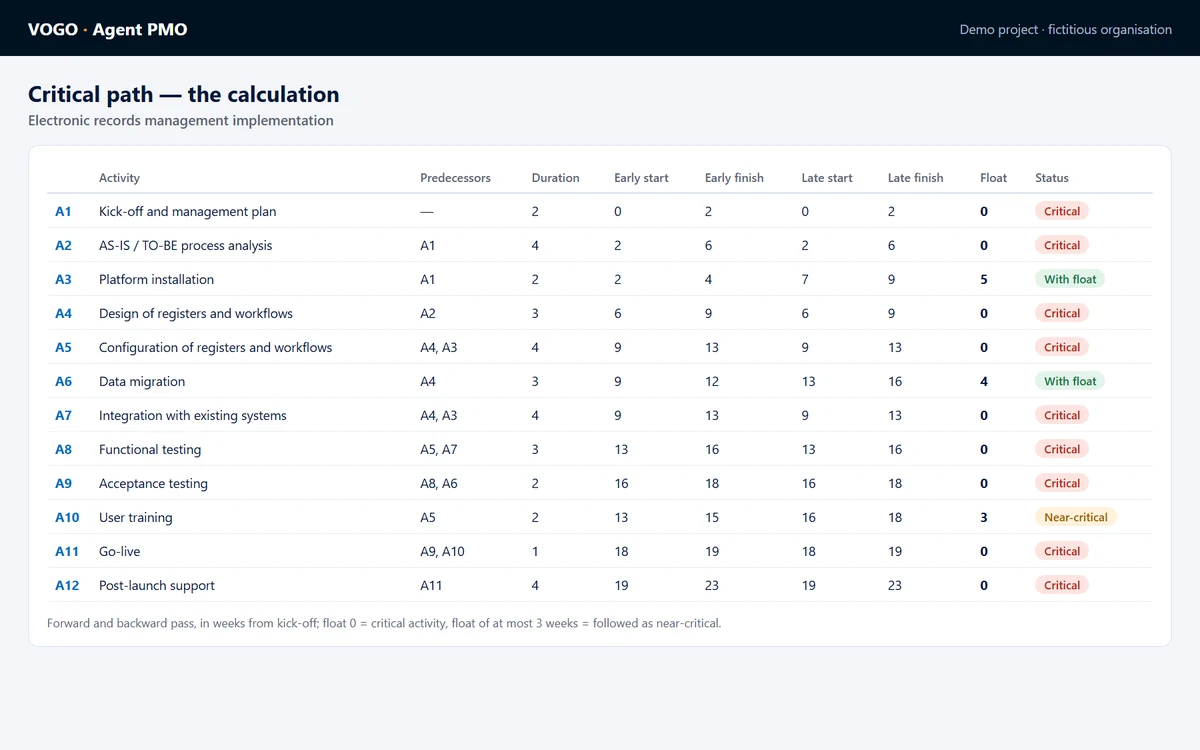

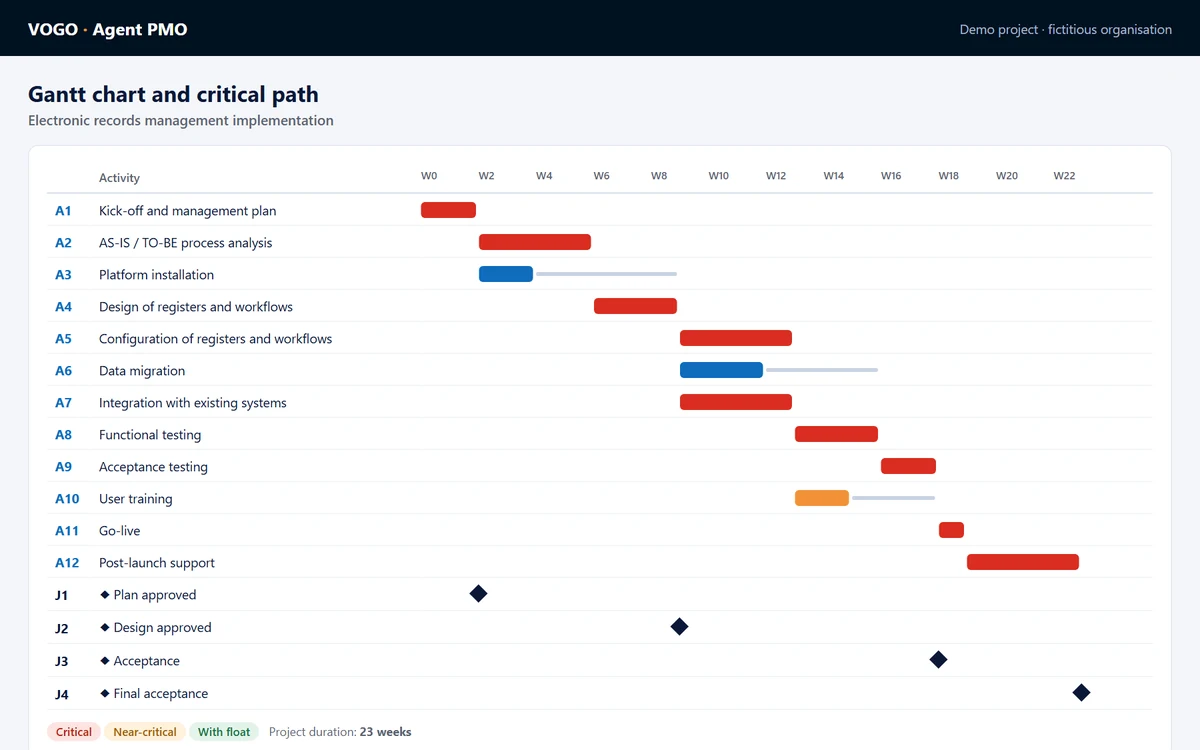

The plan, with the critical path in view
From activities, durations and dependencies, the agent builds the plan and the Gantt chart. Critical activities stand out, the float of the others shows as a line after the bar, and milestones sit at the end of the activities they depend on.
